Converting a dining room is a spectrum of projects, from a paint-and-furniture swap to a full structural knock-through, and the single most useful first step is defining your scope. That decision shapes everything: which trades you need, whether permits are required, how long the project takes, and what it costs.
What each scope level looks like in practice:
Your immediate next steps:
Pro Tip: Before you sketch a single layout, check whether the wall between your dining room and kitchen is load-bearing. That one answer splits your project into two completely different budgets.
Permits and engineering reviews are required any time you touch structural elements, move plumbing, relocate gas lines, or make significant changes to your electrical panel. Skipping them creates liability at resale and can void your homeowner’s insurance.
Defining your scope first, before hiring anyone or buying materials, is the single decision that determines whether a dining room conversion stays on budget and on schedule.
| Point | Details |
|---|---|
| Define scope before anything else | Cosmetic, moderate, and structural conversions differ by thousands of dollars and weeks of timeline. |
| Know your permit triggers | Load-bearing walls, plumbing, gas, and significant electrical work all require permits and inspections in St. Louis. |
| Budget a 15–20% contingency | Structural projects almost always surface surprises once walls open; that buffer prevents mid-project stops. |
| Design for reversibility | Neutral finishes and removable built-ins protect resale value and keep future buyers interested. |
| Expressions Remodeling | Manages design, permits, engineering, and construction for dining room conversions across St. Louis, MO. |
A dining room conversion is the process of repurposing a dedicated dining space into a room that better fits how your household actually lives. The term covers everything from rearranging furniture to knocking through walls, so the phrase “dining room transformation” means something very different depending on who’s using it.
The mechanics are straightforward: you assess the existing room (size, structural elements, utilities), define the new function, determine what physical changes are needed to support that function, and then execute in the right sequence. That sequence matters. Structural work comes first, then rough mechanical work (electrical, plumbing, HVAC), then insulation and drywall, then finishes. Doing it out of order means tearing out finished work to reach pipes or wires behind it.

What makes dining rooms particularly flexible is their typical placement in a home. They sit adjacent to kitchens, often have good natural light, and tend to be underused. A survey found that formal dining rooms ranked among the features buyers were most willing to drop from a new home. That shift in preference is exactly why so many homeowners are now converting dining spaces into rooms they’ll actually use every day.
Thinking about a kitchen remodel in St. Louis? See how we plan and build it on our kitchen remodeling in St. Louis page, including a free 3D design before work starts.
The right conversion depends on your household’s daily friction points. Here are the most common options, with honest notes on what each actually involves.
Home office: The most popular conversion right now. Cosmetic-to-moderate scope. You’ll want a dedicated electrical circuit for equipment, good overhead and task lighting, and possibly a data line or upgraded Wi-Fi access point. No structural work unless you’re adding built-ins that require wall anchoring.
Library or reading room: Mostly cosmetic to moderate. Built-in bookshelves add cost and require a carpenter, but the project rarely touches plumbing or load-bearing elements.
Playroom: Cosmetic to moderate. Durable flooring (LVP or tile over carpet), outlet covers, and possibly a half-wall or barn door for containment. Low disruption.
Open-concept kitchen expansion: Moderate to structural. This is the most complex option. Removing the wall between kitchen and dining room often means dealing with a load-bearing element, relocating HVAC registers, and potentially extending plumbing or gas lines. Expect engineering involvement and permits.
Bar or entertainment nook: Moderate to structural. A dry bar is moderate; a wet bar with a sink adds plumbing and a permit. Electrical for a mini-fridge and under-cabinet lighting is standard.
Pantry or mudroom: Moderate to structural. Adding custom storage solutions and built-ins is moderate. Adding a utility sink or relocating a door opening pushes it into structural territory.
Multipurpose flexible room: Cosmetic to moderate. A fold-down desk, Murphy bed, or modular shelving system keeps the room adaptable. This is the best choice if you want resale flexibility.

| Conversion | Scope level | Typical trades | Disruption |
|---|---|---|---|
| Home office | Cosmetic–Moderate | Electrician | Low |
| Library/reading room | Cosmetic–Moderate | Carpenter | Low |
| Playroom | Cosmetic–Moderate | Flooring installer | Low |
| Open-concept kitchen | Structural | Structural engineer, carpenter, HVAC, electrician | High |
| Bar/entertainment nook | Moderate–Structural | Electrician, plumber (wet bar) | Medium |
| Pantry/mudroom | Moderate–Structural | Carpenter, plumber (if sink) | Medium |
| Multipurpose room | Cosmetic–Moderate | Carpenter | Low–Medium |

The typical sequence runs: plan and measure, design and get estimates, pull permits, demolition, rough mechanical work, insulation and drywall, finishes, and final inspections. Skipping steps or reordering them is the single biggest source of cost overruns on residential projects.
Define scope and measure. Confirm room dimensions, identify load-bearing walls, locate electrical panels, plumbing stacks, and HVAC runs. Take photos of everything.
Design and select materials. Sketch the layout or work with a designer. Nail down flooring, lighting, built-ins, and any mechanical changes before pricing. Vague scopes produce wildly inaccurate estimates.
Get estimates and sign a contract. Get at least two written estimates. The contract should specify scope, materials, timeline, payment schedule, and change-order procedures.
Pull permits. Your contractor typically handles this, but the permit is issued to the homeowner. Structural, electrical, plumbing, and HVAC changes almost always require one. Budget one to three weeks for permit approval in most St. Louis municipalities.

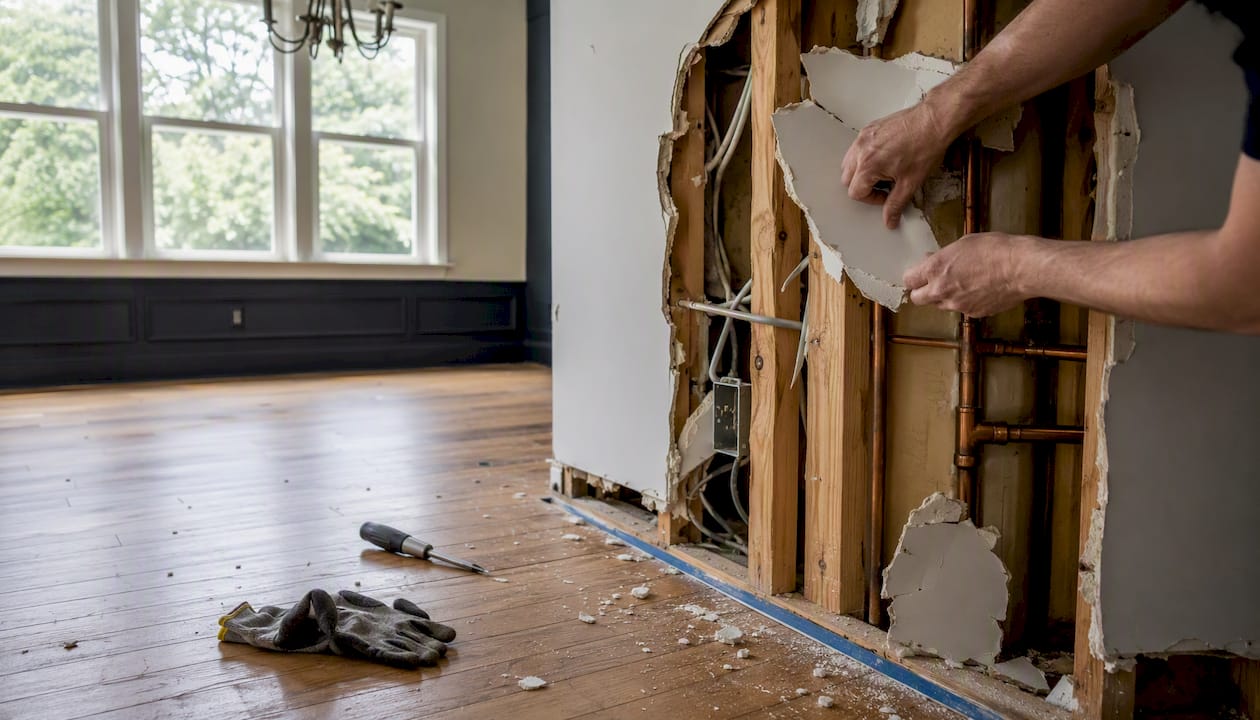

Demolition. Remove existing furniture, flooring, and any walls or fixtures being changed. Structural shoring goes in before any load-bearing wall comes down.
Rough mechanical work. Electricians, plumbers, and HVAC technicians run new lines, circuits, and ductwork before walls are closed. This is the stage inspectors check first.
Insulation and drywall. Once rough work passes inspection, walls and ceilings close up. Drywall, taping, and mudding follow.
Finishes. Flooring, paint, trim, cabinetry, lighting fixtures, and hardware. This is the visible transformation.
Final inspection and punch list. Inspector signs off on permitted work. Contractor walks through the punch list with you to address anything incomplete or not to spec.
Timeline estimates by scope:
Who handles what:
Good furniture arrangement principles apply from day one of planning: establish a focal point, keep walkways clear (at least 36 inches for primary paths), and avoid pushing every piece against a wall. These rules don’t change just because the room’s function does.
The short answer: any time you change the structure, move utilities, or alter the building envelope, you need a permit. Most cosmetic work does not. The gray zone is moderate work, where a single electrical circuit upgrade might require a permit in one municipality and not another.
Common permit triggers:
Self-screening checklist:
If you checked any box, contact your local building department before starting work. In St. Louis County, permits are issued through the Department of Public Works; St. Louis City has its own Building Division.
Removing a load-bearing wall is the most consequential trigger. It requires temporary shoring during demolition, a structural engineer’s stamped drawings, and a beam or supported header sized to carry the load above. The engineering cost is modest relative to the risk of getting it wrong, and those stamped drawings protect you at resale.
Which trades require signed drawings or inspections:
Pro Tip: The moment a project involves a load-bearing wall, live electrical panel work, or gas line relocation, stop DIYing. Homeowner’s insurance policies often exclude damage caused by unpermitted work, and that exclusion can leave you personally liable for a structural failure.
Cost varies more than almost any other home project because the range from cosmetic to structural is so wide. The biggest cost drivers are load-bearing wall removal, plumbing additions, electrical panel upgrades, and finish quality.
Cost ranges by scope (rough estimates for the St. Louis market):
These are ranges, not quotes. A wet bar with custom cabinetry and a tile backsplash costs more than a wet bar with stock cabinets and painted drywall. An open-concept kitchen that requires a steel beam costs more than one that needs only a wood header.
Common causes of schedule delays:
Budget a contingency of 15–20% on top of your contractor’s estimate. Structural projects almost always surface at least one surprise once walls open. That buffer is not pessimism; it’s how experienced homeowners avoid stopping a project mid-construction.
A few precise measurements make the difference between a room that feels right and one that always seems slightly off.
Clearances that matter:
The 2/3 rule for proportion: A rug, piece of artwork, or furniture grouping should occupy roughly two-thirds of the width of its anchor piece or wall. Designers use this as a starting point, not a rigid formula, because exact halves tend to make a room feel staged rather than lived-in. Applied to a dining-room conversion: if your new desk or sofa grouping anchors one wall, the rug beneath it should span about two-thirds of that furniture’s width. The same principle applies to artwork above seating and to furniture groupings in open-plan layouts.
The 4-inch seating rule and chair/table ergonomics: Standard dining chair seat height runs 18–20 inches, which provides 10–12 inches of clearance between the seat top and the underside of a standard 28–30 inch table. If you’re converting a dining room into a mixed-use space that keeps some seating, keep all seat heights within 4 inches of each other across the seating group. Mixing a 17-inch bench with a 22-inch chair at the same table creates visual discord and physical awkwardness.
Lighting layers for a converted space:
Pro Tip: When you convert a dining room to a home office or reading room, resist the urge to fill every wall. Leave at least one wall clear. A room with breathing room reads larger and photographs better when it’s time to sell.
A well-executed, functional conversion typically holds or adds value. A highly personalized or poorly finished one can hurt it. The key variable is reversibility.
Buyer-friendly conversions:
Buyer-limiting conversions:
Seller’s checklist for resale-conscious conversions:
Pro Tip: Document every permit and inspection for work you do in this room. Buyers’ agents ask for permit history, and a clean permit record on a structural conversion is a genuine selling point. Keep copies of engineer-stamped drawings in your home file.
Paint, lighting swaps, furniture arrangement, and basic flooring installation are reasonable DIY territory for a handy homeowner. Anything involving load-bearing walls, live electrical panels, gas lines, or plumbing drain work is not.
DIY-appropriate tasks:
Hire a licensed professional for:
When you’re ready to hire, ask every contractor these questions before signing anything:
Red flags to walk away from:
Payment norms: A reasonable deposit is 10–30% of the project total. Staged payments tied to project milestones (rough-in complete, drywall complete, finishes complete) protect both parties. Withhold a final retainage of 5–10% until the punch list is fully resolved and final inspection is passed.
Pro Tip: Always request a lien waiver from every subcontractor and supplier before making your final payment. Without it, a sub your general contractor didn’t pay can place a lien on your home, even if you paid the GC in full.
Contractor-managed projects reduce risk primarily because one party coordinates permits, engineering, and trade sequencing, so nothing falls through the cracks between subcontractors. Expressions Remodeling’s home modernization process follows a defined workflow that covers every stage from first conversation to final sign-off.
Project workflow:
What the client handles: Design decisions, material selections, timely payments, and change-order approvals.
What Expressions Remodeling handles: Engineering coordination, permit submissions, trade scheduling, site safety, inspections, and final punch list resolution.
Expressions Remodeling brings this same structured approach to kitchen, bathroom, basement, and custom living-space projects across St. Louis, MO. Before-and-after documentation is available through their project portfolio, and the firm’s track record of client satisfaction reflects a consistent focus on delivering what was scoped and signed.
Pro Tip: Ask your contractor to show you the permit card and inspection sign-offs at each milestone. A contractor who welcomes that question is one who’s doing the work correctly.
The more specific your input, the more accurate the estimate and the faster the design process moves. Vague briefs produce vague quotes.
Preparation checklist:
Layout ideas worth considering:
Take photos of the existing room before any work starts. Those “before” images are useful for insurance documentation, permit applications, and the satisfaction of seeing the finished result in context.
Most conversion mistakes aren’t about choosing the wrong function. They’re about underestimating the gap between a cosmetic change and a structural one, and not planning for the temporary disruption the project creates.
A full-service remodeler reduces project risk by managing permits, engineering, and trade coordination under one contract, so you’re not chasing subcontractors or guessing at inspection schedules.

Expressions Remodeling offers St. Louis homeowners a complete dining room conversion service that covers every stage:
Whether you’re converting to a home office, opening up to the kitchen, or adding a pantry, the team at Expressions Remodeling scopes the project honestly, prices it clearly, and delivers what was agreed. View pricing and request a consultation to get a written estimate for your specific project in St. Louis, MO.
The sources below back the design rules, ergonomic guidelines, and process guidance in this article.
