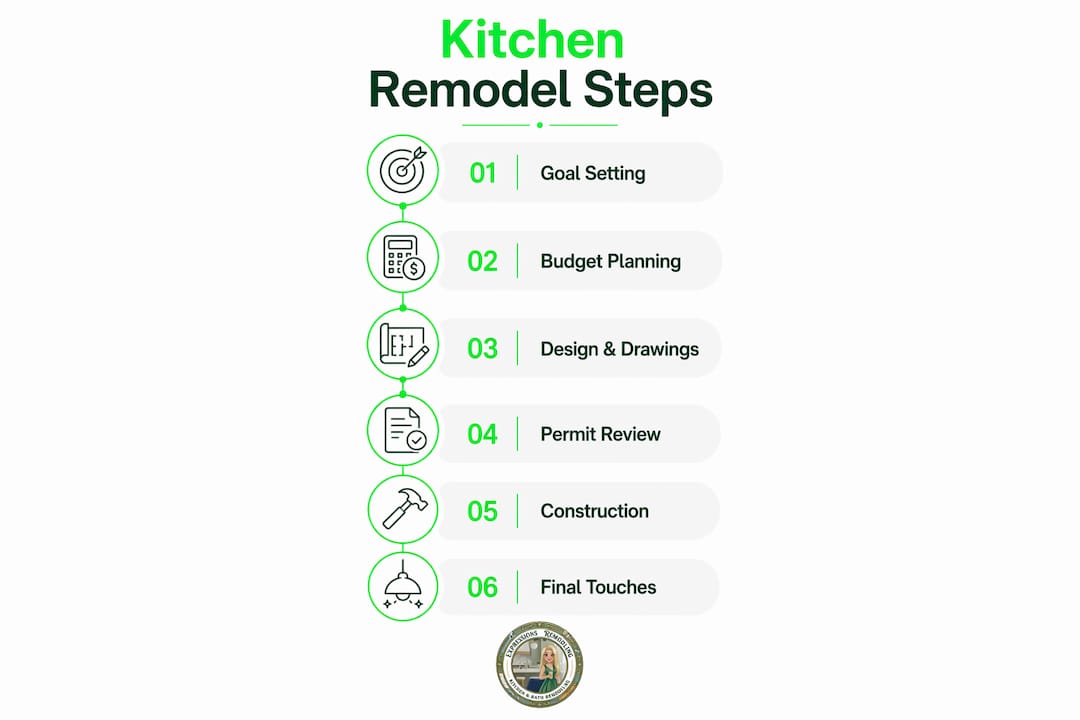

A kitchen remodel is defined as a systematic renovation process covering goal setting, budgeting, design, permitting, and phased construction. When you plan kitchen remodel step by step, you control costs, timelines, and outcomes instead of reacting to surprises. A moderate kitchen remodel typically runs 6–12 weeks from demolition through final installation. Expressions Remodeling works with St. Louis homeowners through every phase of this process, applying precise design planning and quality craftsmanship to deliver kitchens that perform as well as they look. For how we run these steps on real projects, see our kitchen remodeling services in St. Louis.
Every successful kitchen renovation guide starts with two things: a clear list of priorities and a budget built to handle the unexpected. Without both, decisions made in week three will contradict decisions made in week one.
Start by identifying what your current kitchen actually fails at. Common goals fall into three categories:
Once you know what you need, assign rough costs to each category. Standard budget planning divides spending across cabinets, countertops, appliances, labor, and finishing materials. A contingency fund of 10–20% of your total budget covers hidden damage, code upgrades, or material changes discovered mid-project. That buffer is not optional. Demolition regularly reveals plumbing leaks, outdated wiring, or structural issues that were invisible before work started.
Ranking your priorities before you spend a dollar is the single most effective budgeting discipline. If a professional-grade range is non-negotiable, that number anchors your budget and everything else scales around it. If storage is the top priority, you allocate more to cabinetry and pull back on countertop material. This approach, covered in depth in Expressions Remodeling’s guide on balancing style and budget, prevents the most common budget failure: spending evenly on everything and excelling at nothing.
Pro Tip: Write your top three remodeling goals on paper before your first contractor meeting. Contractors bid more accurately when you hand them a ranked priority list rather than a vague wish list.
Layout planning is where most homeowners underestimate the complexity of a kitchen renovation. The physical conditions of your existing kitchen determine what is possible before any design decisions are made.
Start with a thorough inspection of three systems:
After the inspection, evaluate your current layout honestly. The most functional kitchen layouts follow the work triangle principle, placing the sink, stove, and refrigerator at three points of a triangle with minimal crossing traffic. Common layout types include galley, L-shaped, U-shaped, and island configurations. Each has specific square footage requirements and traffic flow implications.

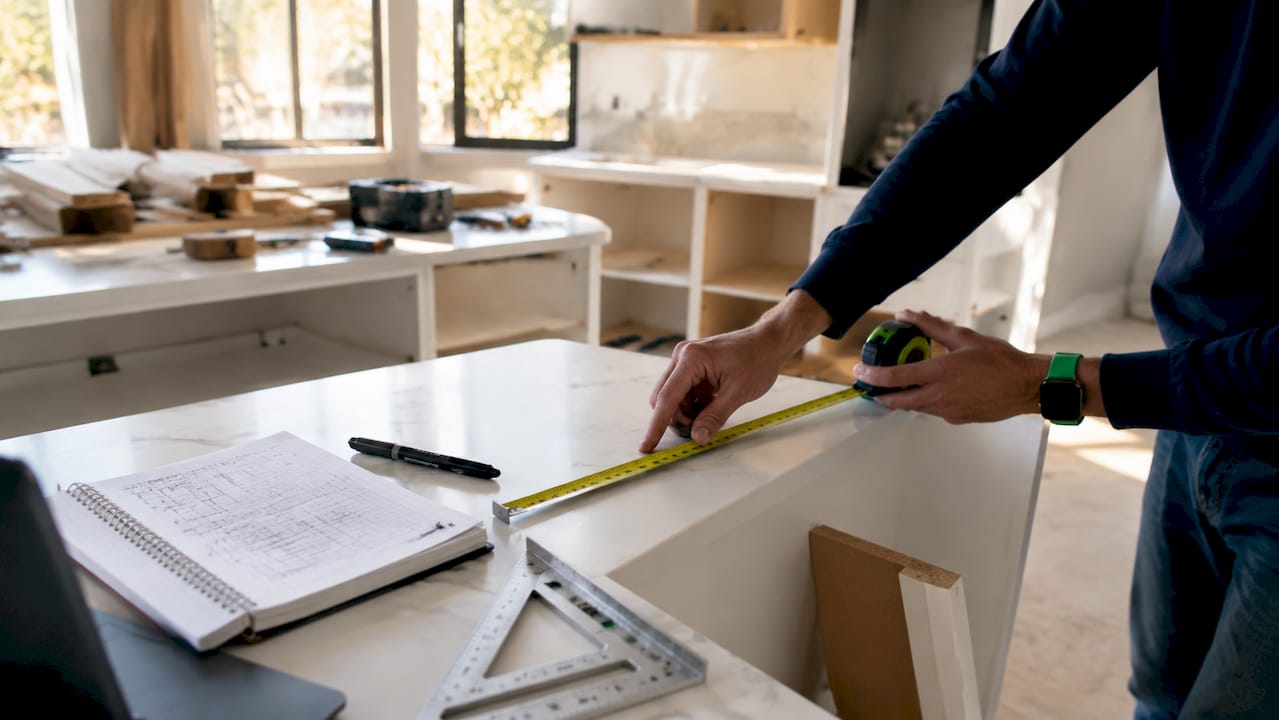

Precise measurements are non-negotiable at this stage. Measure ceiling heights, note trim clearances, and document every cabinet door swing. Errors in measurement at the planning stage become expensive change orders during installation. A site sketch that captures these details prevents installation misfits that delay the entire project.

3D renderings and visualizations help homeowners see the finished space before a single wall comes down. That preview catches functional problems, like a cabinet door that blocks a walkway, before they become construction problems. Expressions Remodeling offers complimentary 3D design sessions for this exact reason.
Pro Tip: Ask your designer to model the kitchen with cabinet doors fully open. A layout that looks great in a floor plan can fail completely when doors and drawers are in use simultaneously.
Permitting is the phase most homeowners treat as a formality. It is not. Design and drawings take 6–10 weeks, and permit review adds another 8–12 weeks on top of that. That combined timeline means permitting must start in parallel with design, not after it.
Here is the standard sequence for this phase:
The table below shows typical durations for each pre-construction phase:
| Phase | Typical Duration |
|---|---|
| Design and drawings | 6–10 weeks |
| Permit review | 8–12 weeks |
| Contractor selection | 2–4 weeks |
| Material lead time (cabinets) | 6–12 weeks |

Contractor and material scheduling must be treated as a single coordinated system. Ordering cabinets before confirming your contractor’s start date creates a storage problem and a cost. Confirming a contractor before permits are approved creates a scheduling conflict. The two tracks run simultaneously, not sequentially.
Engaging an architect early when structural changes are planned connects your kitchen design to the home’s overall systems, including HVAC routing and load-bearing considerations. That connection prevents expensive redesigns later.
Pro Tip: File your permit application the same week your design drawings are finalized. Treating permitting as an early parallel task rather than a post-design step can save 8–12 weeks of project time.
The construction phase of a kitchen remodel follows a fixed sequence. Skipping steps or reordering phases creates rework and added cost.
The standard order of operations runs as follows:
Managing life during construction requires planning well before demolition day. Living in a construction zone means setting up a temporary kitchen with a microwave, coffee maker, and mini-fridge in another room. Map out which days will have no running water and plan around them. Communicate those dates to your household in advance.
Key practices that keep construction on track:
Pro Tip: Reserve a separate punch-list fund of $500–$1,000 for small corrections and touch-ups after the main work is done. Final inspections almost always surface minor items that need attention.
The most costly remodeling mistakes share a common cause: decisions made too fast, too early, or without enough information.
The most frequent pitfalls homeowners encounter include:
“Design for how you actually cook, not for how the kitchen looks in photos. Function determines whether you love the space in ten years.”
Unexpected demolition findings are not a sign of a bad project. They are a normal part of remodeling older homes. Your contingency budget exists precisely for this. When a contractor opens a wall and finds outdated knob-and-tube wiring, the right response is to address it immediately, not defer it.
On-site communication is the most underused tool in a remodel. Visiting the site regularly and asking specific questions about sequencing and material choices prevents misunderstandings that show up as expensive surprises at the end.
Pro Tip: Before signing off on any phase, walk through the space with your contractor and a copy of the original drawings. Compare what was planned with what was built. Catching a discrepancy during construction costs far less than correcting it after.
A kitchen remodel succeeds when planning, permitting, and construction are treated as one connected sequence rather than three separate events.
| Point | Details |
|---|---|
| Start with ranked priorities | Define your top three goals before budgeting to keep spending focused and decisions consistent. |
| Build in a contingency fund | Allocate 10–20% of your total budget for unexpected conditions found during demolition. |
| Start permitting early | Submit permit applications alongside design drawings to avoid 8–12 weeks of avoidable delay. |
| Sequence construction correctly | Install cabinets before flooring to achieve clean finishes and preserve future flexibility. |
| Align contractor and materials | Confirm contractor availability before ordering long-lead items like custom cabinets. |
The homeowners who have the smoothest remodels share one trait: they spend more time planning than they expected to. Not because they are cautious by nature, but because they discovered early that every hour spent in the design phase saves three hours on the job site.
The 3D visualization step is the one most homeowners initially want to skip. They see it as a nice extra, not a necessity. Every time someone skips it, they end up requesting a change order mid-construction because a cabinet placement that looked fine on paper blocked a window or a traffic path. The rendering session pays for itself in avoided change orders alone.
Permitting is the other area where I consistently see homeowners lose weeks of time. They treat it as the last administrative step before construction starts. Permit review takes 8–12 weeks. Starting it late does not delay construction by a few days. It delays it by months. Filing the permit application the same week drawings are finalized is the single scheduling decision that most compresses the overall timeline.
The last thing I would tell any homeowner is this: function over fashion is not a compromise. It is the standard that determines whether you still love your kitchen in year ten. A beautiful countertop material that stains easily or a layout that forces awkward traffic patterns will frustrate you every single day. Design for how you live, then make it look great within that constraint.
— Kierin
Expressions Remodeling brings St. Louis homeowners through every phase of a kitchen renovation, from the first priority conversation to the final punch-list walkthrough. The team combines precise design planning with quality craftsmanship to deliver kitchens that fit how you actually live.

Whether you are starting with a blank budget or a half-formed layout idea, Expressions Remodeling’s process begins with a complimentary 3D design session that makes your priorities visible before any work starts. Explore affordable kitchen upgrade options or connect with the team directly to schedule your consultation. For homeowners in St. Louis looking to stay on budget without cutting corners, the kitchen remodeling planning guide is a strong starting point.
A moderate kitchen remodel runs 6–12 weeks for construction, but the full timeline including design and permitting can extend to 6 months or more. Starting permit applications early is the most effective way to compress the overall schedule.
Allocate 10–20% of your total project budget as a contingency. This covers unexpected conditions like outdated wiring, water damage, or structural issues found during demolition.
Cabinets go in first, on the subfloor. Flooring is then installed up to the toe kicks, which creates a cleaner finish and makes future cabinet replacement easier without damaging the floor.
Submit your permit application the same week your design drawings are finalized. Permit review takes 8–12 weeks, so treating it as a parallel task rather than a final step saves significant time.
An architect is necessary when structural changes are involved, such as removing a load-bearing wall or relocating plumbing and electrical systems. For cosmetic updates within the existing footprint, a kitchen designer is typically sufficient.
